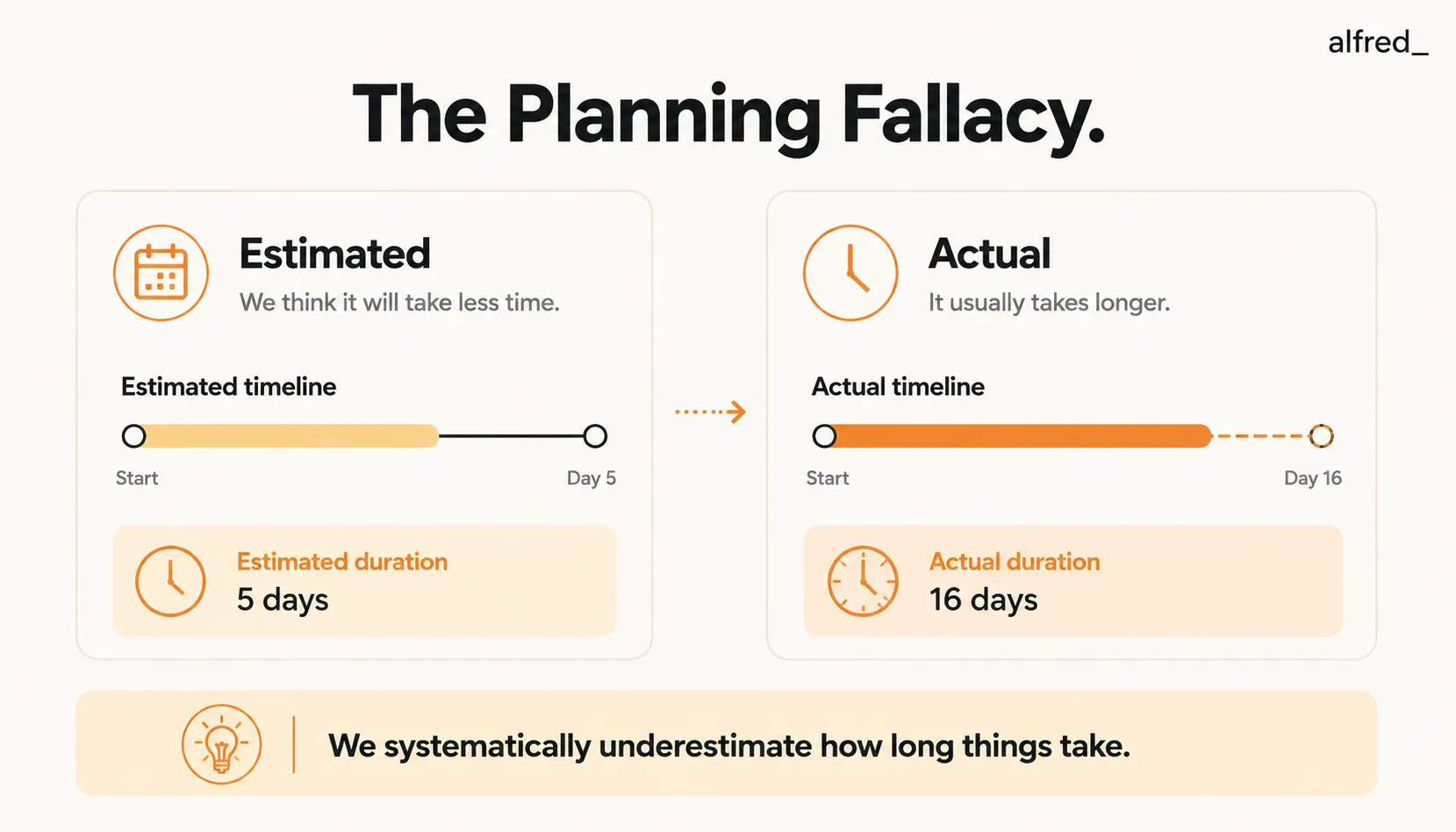

The Planning Fallacy: Why Every Project You've Ever Run Was Late
Projects are late. Universally, systematically, and predictably late. Not because the people running them are incompetent, but because of a cognitive bias so deeply embedded in how humans plan that even people who know about it continue to fall for it. Kahneman and Tversky named it the planning fallacy in 1979. Here is the mechanism and the fix.
What is the planning fallacy?
- The planning fallacy is the systematic tendency to underestimate project time, cost, and risk, identified by Kahneman and Tversky in 1979
- The mechanism is the "inside view": planners focus on the specific plan's steps rather than consulting the statistical distribution of outcomes for similar past projects
- The fix is the "outside view" (reference-class forecasting): find actual completion data for comparable projects and start estimates from that distribution, not from the plan's internal logic
- Even people who know about the bias continue to fall for it. Hofstadter's Law: "It always takes longer than you expect, even when you take into account Hofstadter's Law"
The Sydney Opera House: estimated at $7M and 4 years, final cost $102M and 14 years. The Boston Big Dig: estimated at $2.8B, final cost $14.6B. The pattern is domain-independent.
The Mechanism: Inside View vs. Outside View
Kahneman and Tversky's insight was not that people are optimistic. It is that they are looking at the wrong information. When planning a project, people naturally adopt what Kahneman calls the inside view: they focus on the specific features of this particular plan, think through its steps, and estimate how long each step will take if things go reasonably well.
The inside view is not irrational on its face. The problem is that it ignores an entire category of relevant information: the statistical distribution of outcomes for similar projects in the past. How long do projects like this actually take? What proportion come in on time? What is the median overrun?
This is the outside view, and it is almost never consulted during planning, because planners are mentally absorbed in the details of the plan they are building. The result is that even experienced project managers, who have watched dozens of projects run over schedule, underestimate the timeline on the next one.
"The outside view is not natural or intuitive. It is a deliberate act of self-distancing from the plan you are building and looking at what actually happened to similar plans before."
Daniel Kahneman, Thinking, Fast and Slow (2011)
Hofstadter's Law
Douglas Hofstadter captured the recursive quality of the bias in Gödel, Escher, Bach (1979):
"It always takes longer than you expect, even when you take into account Hofstadter's Law."
The recursion is real. Even people who are aware of the planning fallacy and consciously try to correct for it still underestimate. Knowing about the bias provides some protection, but not immunity. The corrective is methodological, not attitudinal.
Try alfred_
See what this looks like in practice
alfred_ applies these principles automatically — triaging your inbox, drafting replies, extracting tasks, and delivering a Daily Brief every morning. Theory becomes system. $24.99/month. 30-day free trial.
Try alfred_ freeWhy Intelligence Does Not Help
The planning fallacy is not a product of naivety or inexperience. It affects experts more than novices in many domains, because experts are more capable of constructing detailed, plausible-sounding plans, which only strengthens their confidence in the inside view. The Sydney Opera House, estimated at $7 million and 4 years, took $102 million and 14 years. The Boston Big Dig: estimated at $2.8 billion, final cost $14.6 billion.
The pattern appears in software development, construction, scientific research, policy initiatives, and personal projects with equal consistency. The domain changes; the bias does not.
The Fix: Reference-Class Forecasting
Kahneman's solution is methodological. Before finalizing any plan, deliberately adopt the outside view:
- Identify the reference class. Find projects that are genuinely comparable: similar scope, team size, domain, and organizational context.
- Find the distribution. What percentage of comparable projects came in on time? What is the median overrun? What is the 80th percentile?
- Start from the median. Use the median outcome for comparable projects as your baseline estimate, then adjust for specific features of this project that make it genuinely different from the reference class.
- Apply an uplift. Even after this adjustment, Kahneman recommends adding a further buffer, because the inside view will still be influencing the "adjustment" step.
The most reliable source of reference-class data is your own organization's history. Project retrospectives that capture actual vs. estimated timelines for past projects give you a reference class calibrated to your specific context, which is more accurate than industry benchmarks.
Why Plans Feel Right Even When They Are Wrong
The inside view feels rigorous. You have thought about every step. You have accounted for dependencies. The timeline looks tight but achievable. This experience of thoroughness is itself misleading: it signals that you have done the work of planning, not that your plan is accurate. Thoroughness in the wrong frame of reference (inside view) produces confident inaccuracy.
Kahneman describes the planning fallacy as having a neural component: optimism about future timelines involves the suppression of negative scenarios in the amygdala and rostral anterior cingulate cortex. The bias is not merely a reasoning error but has a motivational and emotional substrate that resists correction by insight alone.
Frequently Asked Questions
Does the planning fallacy affect individuals or only organizations?
Both. The same bias operates when you estimate how long a personal task will take, how long a workout routine will take before you see results, or how quickly you will finish a home improvement project. The inside-view mechanism is domain-independent. Reference class forecasting also works at the individual level: track your actual task completion times versus estimates and use that data to calibrate future estimates.
If everyone knows about this bias, why does it persist?
Because correcting it requires deliberate method, not just awareness. Knowing about the planning fallacy does not stop the brain from adopting the inside view. It only means you can recognize that you are probably doing it. Actual correction requires the outside-view methodology: finding real completion data for comparable projects and starting estimates from that data rather than from your plan's internal logic. Most project planning processes do not build in this step.
What about stakeholder pressure? Accurate estimates are often rejected as too slow or too expensive.
This is a real organizational dynamic. Kahneman describes this as 'strategic misrepresentation': planners know their estimates are optimistic but produce them anyway because stakeholders reward optimism and punish realistic estimates. The solution is separating the planning forecast from the negotiation conversation. Produce an accurate reference-class estimate, present it with the underlying data, and then negotiate scope or resources, not the estimate's accuracy.
Is there any domain where the planning fallacy does not apply?
Domains with very rapid, tight feedback loops and standardized tasks (manufacturing repetitive units, call-center operations) show less planning fallacy because the reference class is immediately visible and enforced by the process. Novel, complex, knowledge-work projects with many interdependencies show the strongest effect, which is most of what executives and knowledge workers actually spend time on.
